The Project Manager is an Expert in Business Intelligence

What if I told you that a Gantt Chart was a form of Business Intelligence (BI)?  Wait, hear me out.

Wikipedia tells me that BI is “the set of techniques and tools for the transformation of raw data into meaningful and useful information for business analysis purposes.”  Yep, sounds like a Gantt Chart to me.

master_aerospace_program_schedule Continue reading

OnePager Tip: Shorten Task Names for Clarity

Prior to using OnePager, you didn’t have to consider how much space your project plan’s task or milestone labels would consume in a chart. Regardless of how long they were, you always had to re-type them anyway into whatever other application you were using to create your reports — and most people shortened labels while retyping.  But now that you’re using your actual plan data to drive your visuals, label length is a major consideration.

Take a look at the examples below.  The first has very long labels, while the second uses only what is necessary for the audience to understand what the activity or milestone is.  (Double-click to enlarge each image.)

Too Much Text - Long Task Names Continue reading

Resources and Cost – A Community Garden

We get asked a LOT what OnePager can provide in terms of displaying resource and cost data.  The question doesn’t come in a specific way.  It really is this generic: “Can you display resource and cost data?”

First, let’s answer the question:  YES.
Continue reading

Making Multi-Project Graphs from Separate Microsoft Project Plans

OnePager Pro has always been able to build multi-project graphs from Microsoft Project integrated master schedules. Now, OnePager Pro 5.0 can make multi-project graphs from separate Microsoft Project plans, even if you haven’t linked them together in an IMS.

We’ll show you how to do this in this short article. Just follow these steps:

Load the first Microsoft Project plan, “Project A”, which is shown below:

Go to the Microsoft Project Add-ins tab, and click on the OnePager Pro button. When the start screen appears, choose the NEW option.

On the import wizard, click the Change button in the upper-right to change your template to “Multi-Project Gantt Chart – Detailed”. This is an important step to combine multiple MS Project plans into a single report:

multi-project-instr1

Click the Create new project view button and OnePager will create a graphic that looks like this:

All four of the tasks are grouped into one large swimlane labeled “Project A”. Note that the Project Name in the graph is the label (name) of the project-summary task and not the name of the Microsoft Project plan.

Now, go back to Microsoft Project and open Project B:

Launch OnePager Pro from this second Microsoft Project plan. Now instead of creating a new project view, tell OnePager that you want to UPDATE:

multi-project-instr2

On the import wizard, make sure you are updating the project view that you created just a minute ago. You want to ensure that you are going to REPLACE existing snapshot:

multi-project-instr3

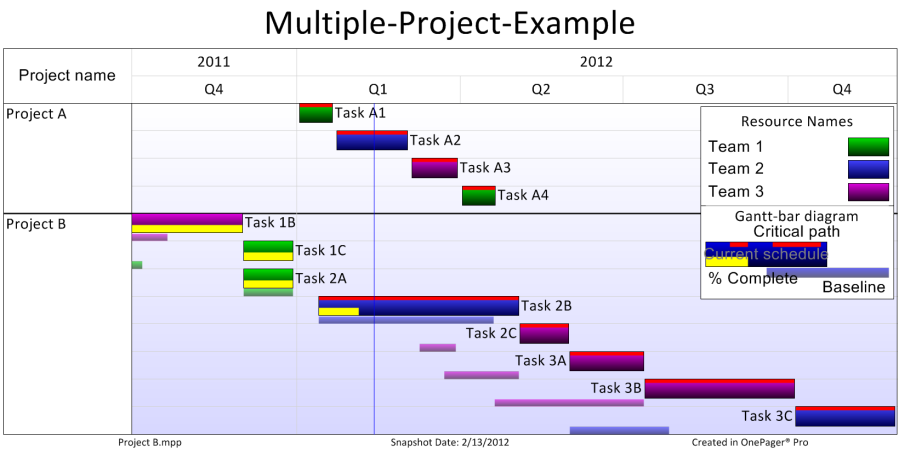

Click the yellow Replace dates button, and OnePager Pro will import the second project, placing it in a swimlane below the first:

It’s that easy. You can now merge other projects into the “Multi-Project-Example” view to summarize as many subprojects as you need.
