Airport Runway Remediation Milestone Plan

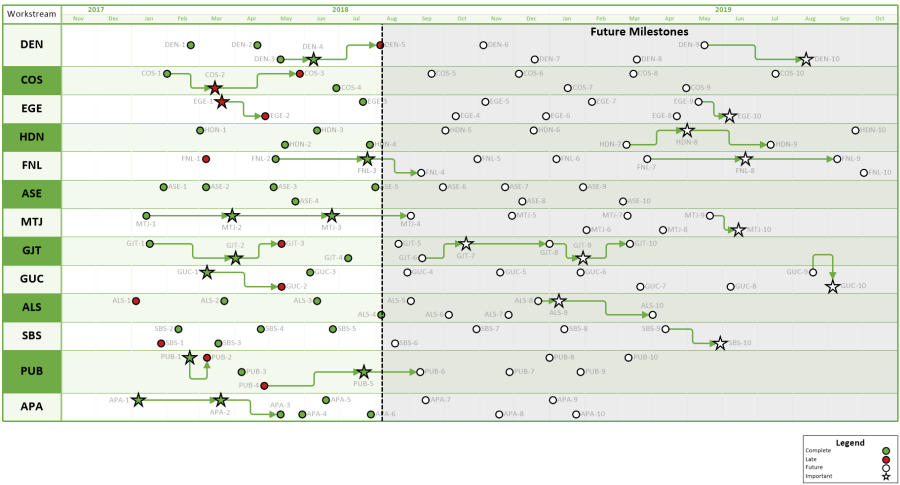

This project schedule, created in OnePager Express, is based on several schedules from Oracle Primavera P6. It shows a series of sequential milestones related to airport runway remediation at several different airports.

Show a series of milestones for multiple airport runway remediation projects.


Download Airport Runway Remediation Milestone Plan as PDF      Download Airport Runway Remediation Milestone Plan as Image

OnePager Express Milestone Plan Features

The milestone plan features:

  • Import of multiple Oracle Primavera P6 schedules into a single report.
  • Grouping milestones for each airport into a swimlane.
  • Aligning multiple milestones into a single row to maximize space, and to show the sequence of events.
  • Assignment of color based on whether a milestone is complete, late, or in the future.
  • Assignment of different shapes based on whether a milestone is important or standard.
  • Automatic import of predecessor (dependency) information from P6 to show relationships between milestones.
  • Insertion of a curtain at today's date to distinguish future milestones from milestones that should have already been completed.

This airport runway remediation project milestone schedule was created using OnePager Express, a project reporting tool that uses data exported from Oracle Primavera P6.

To learn more about OnePager, and see how it can help you track key milestones across multiple projects, get started today by downloading a free trial.
